Paper Cup Machine:Factory Checklist

Publish Time:2026-07-24 03:43
Table of Contents

Table of Contents

What Should Buyers Confirm Before Purchasing?

A machine for the manufacture of paper cups should be purchased only after the buyer confirms cup size demand, paper cup fan supply, target output, packing method, workshop conditions, operator plan, and first-order cash flow. The machine is important, but it is not the whole business. A factory earns money when formed cups become accepted, packed, and delivered products.

Many buyers ask first about machine price, speed, and model. Those questions matter, but the safer starting point is the factory plan. Which cups will sell first? Will the factory buy ready paper cup fans or add printing and die cutting later? How many workers will inspect and pack cups? What packing quantity do customers expect?

For buyers comparing a paper cup machine, the goal is not to buy the most complicated setup immediately. The goal is to choose equipment that supports confirmed orders without creating unnecessary material, labor, or cash-flow pressure.

What Does This Machine Include in Real Factory Use?

In practical factory language, a machine for the manufacture of paper cups usually means a forming machine that turns paper cup fans and bottom paper into finished cups. It feeds the fan, seals the side wall, feeds bottom paper, heats and seals the bottom, curls the rim, and discharges the cup. However, the factory still needs raw material preparation before forming and packing after forming.

Factory Stage What Is Needed Why Buyers Should Care
Before forming Paper cup fan, bottom paper, printing, die cutting, storage Material problems quickly become machine stoppage and waste
During forming Stable feeding, sealing, bottom forming, curling, discharge Accepted output decides daily production value
After forming Inspection, counting, bagging, sealing, carton packing Unpacked cups cannot become deliverable orders

Factory Readiness Before Installation

Installation is easier when the buyer prepares the workshop before the machine arrives. The workshop should have enough space for material storage, machine operation, inspection, packing, finished goods, and maintenance access. If space is too tight, operators may waste time moving materials and formed cups instead of controlling output quality.

  • Reserve dry storage for paper cup fans, bottom paper, bags, cartons, and spare parts.
  • Keep a clear path from raw material to forming, inspection, packing, and finished cartons.
  • Prepare power, air, ventilation, lighting, and operator working space according to the machine plan.
  • Set a simple inspection area for leakage, side seam, rim shape, stacking, and packing quantity.
  • Plan how rejected material and sample cups will be separated from saleable cups.

A good workshop layout reduces hidden labor cost before production even starts.

Which Configuration Fits Different Buyers?

Buyer Type Suitable First Configuration Reason
Startup factory One forming machine, ready fans, simple manual or semi-manual packing Keeps investment focused while customer demand is tested
Local distributor Forming machine plus stronger counting and packing support Delivery speed and packing consistency are often the bottleneck
Coffee cup supplier Forming machine with reliable printed fan supply or later printing plan Branded cups need artwork control and repeat material planning
Existing factory Upgrade the measured bottleneck: forming, fan preparation, or packing Expansion should solve the stage that limits profit today

How Paper Cup Fan Planning Affects Success

A machine can only manufacture stable cups when the paper cup fan, bottom paper, coating, and mold are matched. If the paper fan shape is inaccurate, the coating is uneven, the paper stiffness is unsuitable, or the bottom paper does not match the cup size, the factory may face feeding stops, weak sealing, leakage, and rejected cups.

For a new buyer, ready paper cup fans can reduce startup complexity. In-house printing and die cutting can improve control later, but only when repeated orders justify the extra equipment, operators, setup waste, and material responsibility. Raw material strategy should follow order stability, not only the desire to own every process.

Practical material rule

Before buying equipment, confirm the first three cup sizes, paper weight, coating type, fan supplier, bottom paper width, and storage conditions.

A Simple Pre-Purchase Cost Formula

Machine price is only one part of paper cup factory investment. Buyers should calculate enough working capital for material, molds, spare parts, packing materials, cartons, labor, training, and first orders. This helps prevent a common problem: the machine arrives, but the factory cannot run stable production because material or packing preparation is incomplete.

Startup investment check

Initial production budget = machine cost + molds + paper cup fan stock + bottom paper + packing materials + spare parts + operator training + working capital for first orders

The buyer should also estimate saleable cups per shift, not only cups per minute. If packing cannot keep up with forming, or if material causes high reject rates, the real return will be lower than expected.

What to Check During Machine Acceptance

Machine acceptance should test more than whether the equipment can run. It should show whether the machine can produce the buyer's target cups repeatedly, with stable sealing, acceptable appearance, and manageable waste. If possible, the test should use material close to the buyer's real production material.



Acceptance Point What to Observe Business Value
Feeding stability Fan feeding, bottom paper feeding, stop frequency Protects output and reduces material waste
Cup quality Side seam, bottom seal, rim curl, leakage, stacking Protects customer repeat orders
Operator routine Daily cleaning, adjustment, lubrication, and inspection steps Reduces downtime after installation
Packing connection Cup collection, counting method, bag quantity, carton workflow Turns formed cups into deliverable orders faster

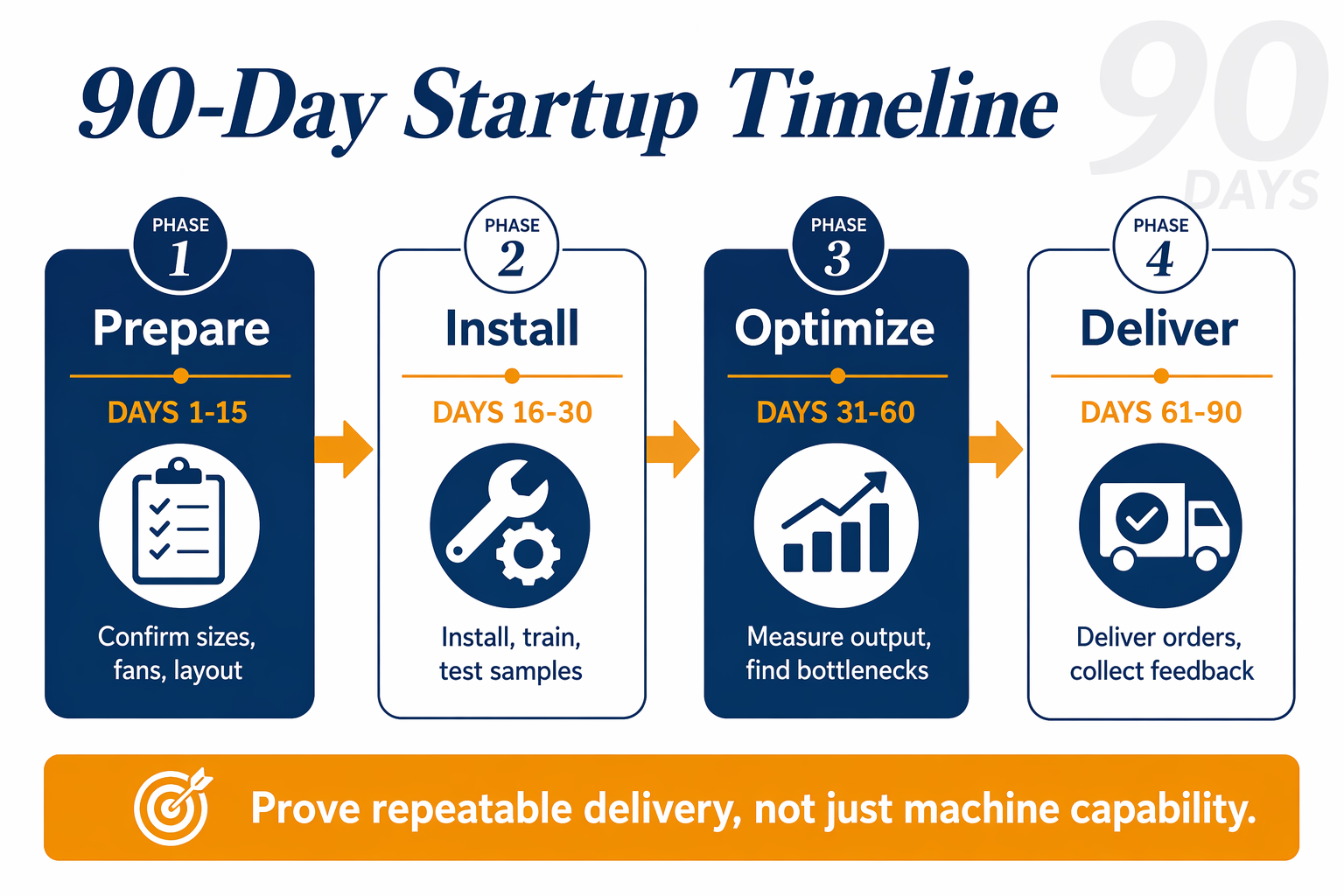

A Practical 90-Day Startup Timeline

After choosing the equipment, buyers still need a practical startup plan. The first 90 days should not be treated only as machine installation time. They should be used to stabilize material supply, train operators, test cup quality, prepare packing standards, and turn trial production into real customer delivery.

Startup Period Main Work Decision Goal
Days 1-15 Confirm cup sizes, fan supply, workshop layout, power, and packing materials Make sure the machine can be installed without avoidable delays
Days 16-30 Install equipment, train operators, and run first cup samples Check whether material, mold, and machine settings match
Days 31-60 Measure accepted output, rejects, stops, packing speed, and operator routine Find the first real bottleneck before scaling orders
Days 61-90 Deliver trial orders, collect customer feedback, and adjust production records Decide whether to stabilize, add molds, improve packing, or prepare an upstream upgrade

The first 90 days should prove the factory can deliver repeatable cups, not just prove that the machine can run.

Mistakes That Delay First Orders



  1. Ordering equipment before confirming the first saleable cup sizes.
  2. Preparing the machine but not preparing enough paper cup fans, bottom paper, bags, and cartons.
  3. Assuming every forming problem is mechanical when material matching may be the cause.
  4. Accepting too many custom sizes and printed orders before production is stable.
  5. Ignoring packing labor and letting formed cups wait in the workshop.
  6. Failing to keep production records for output, rejects, stops, and customer complaints.

Final Buying Checklist

  • Confirm first cup sizes, target markets, and monthly order expectations.
  • Decide whether the first stage uses ready fans or in-house printing and die cutting.
  • Prepare workshop layout for material, forming, inspection, packing, and finished goods.
  • Calculate startup budget including molds, raw material, packing, spare parts, and working capital.
  • Plan operator training and daily machine care before production begins.
  • Define acceptance tests for the actual cups the factory plans to sell.
  • Prepare production records so future upgrades follow real bottlenecks.

Frequently Asked Questions

Is one machine enough to start manufacturing paper cups?

One forming machine can be enough for a startup if the buyer has ready paper cup fans, a limited size range, basic packing, and confirmed target customers. More equipment can be added when orders become stable.

Should printing and die cutting be purchased at the same time?

Not always. They make more sense when printed cup orders repeat often enough to justify setup cost, labor, material storage, and artwork approval work.

What matters more than machine speed?

Accepted output per shift matters more. This includes real running time, rejects, material quality, operator skill, inspection, and packing capacity.

How can buyers reduce startup risk?

Start with a focused product mix, reliable material supply, clear packing standards, operator training, and conservative output expectations. Avoid buying every process before demand is proven.

When should a factory upgrade after the first machine?

Upgrade when production records show a repeated bottleneck, such as forming capacity, paper fan supply, packing speed, or custom printing lead time. The next machine should solve a measured problem.

The Bottom Line

A machine for the manufacture of paper cups should be selected as part of a complete factory plan. Buyers need to confirm cup demand, material supply, workshop readiness, packing method, working capital, and acceptance standards before making the purchase.

When discussing equipment with a manufacturer, send the target cup sizes, paper type, expected daily output, packing quantity, workshop conditions, and upgrade plan. This information helps the supplier recommend a practical configuration instead of only quoting a general model.

The safest first investment is the configuration that can deliver the buyer's first repeat orders reliably, not the configuration that looks the most complete on paper.

Before buying, prepare a simple factory checklist covering cup sizes, fan supply, molds, packing, workshop layout, operators, and cash flow. This makes the quotation more accurate and gives the factory a clearer path from machine installation to stable paper cup sales.
